Work Packages & Deliverables

In this section you will find an up-to-date overview of all deliverables within ReHydro, including their status of completion.

Public” – Available to view and download in the Knowledge Hub here on the project website.

Pending review” – Completed on time but will only become available to the public once approved by the European Union.

Sensitive” – Will not be shared with the public.

WP1 Improved hydropower refurbishment performance M1-30 2/3
Progress

Development of new digital monitoring systems that measure the condition and efficiency of hydropower turbines in real time without shutting down the plant. The goal is to optimise maintenance intervals and improve overall performance.

  • D1.1 - Demonstration of monitoring technologies

    Due October 2025 | Sensitive

  • D1.2 - Monitoring technologies

    Due April 2026 | Pending review

  • D1.3 - Abrasion monitoring

    Due October 2026

Progress

Testing innovative technologies to make existing hydropower plants more flexible, for example by combining them with battery storage or retrofitting pumping systems. This allows plants to respond better to fluctuating electricity demand.

  • D2.1 - Initial studies for retrofitting with pumped storage

    Due July 2025 | Sensitive

  • D2.2 - Control algorithm for hybrid systems

    Due October 2025 | Sensitive

  • D2.3 - Retrofitting with pumped storage technology

    Due October 2026

  • D2.4 - Hybridization and digitalization

    Due April 2027

Progress

Analysing the economic opportunities that hydropower modernisation offers, and identifying which markets and revenue streams will be relevant in the future.

  • D3.1 - Business outlook

    Due April 2026 | Pending review

  • D3.2 - Multimarket model

    Due April 2026 | Sensitive

Progress

Developing and testing solutions that make hydropower modernisation more environmentally friendly, for example through eel-friendly turbine designs and measures to restore natural water flows.

  • D4.1 - Eel-friendly turbine development plan

    Due April 2025 | Sensitive

  • D4.2 - Eel friendly turbine design

    Due October 2026

  • D4.3 - Environmental flow

    Due October 2026

Progress

Investigating the broader benefits that modernised hydropower plants can offer to society such as managing floods and droughts, supporting recreational use of waterways, and protecting biodiversity.

  • D5.1 - Hydropower pressures assessment

    Due July 2025 | Public

  • D5.2 - Matrix of future water uses

    Due September 2025 | Public

  • D5.3 - Goal and scope of Life Cycle Assessment

    Due October 2025 | Public

  • D5.4 - River digital services description

    Due April 2026 | Pending Review

  • D5.5 - Services for society

    Due October 2026

  • D5.6 - Result of Life Cycle Assessment applied to the refurbishment scenario

    Due October 2026

  • D5.7 - Biodiversity footprint

    Due October 2026

Progress

Transferring the solutions developed in WP1-5 to additional sites across Europe and developing a decision support tool to help operators choose the best modernisation option for their site.

  • D6.1 - Upscaling sustainability solutions

    Due April 2027

  • D6.2 - Upscaling environmentally friendly solutions

    Due April 2027

  • D6.3 - Climate Resilience Guide: comments and recommendations

    Due April 2027

  • D6.4 - Decision support framework

    Due October 2027

Progress

Bringing together all project results into practical guidance documents for industry and policymakers, with the aim of enabling the large-scale modernisation of European hydropower plants.

  • D7.1 - White Book

    Due February 2028

  • D7.2 - Benefits from modernisation

    Due March 2028

  • D7.3 - Modernisation and EU long-term strategy

    Due April 2028

Milestones

This is the timeline of all completed and future milestones within ReHydro as well as their dates of completion.

May 2024

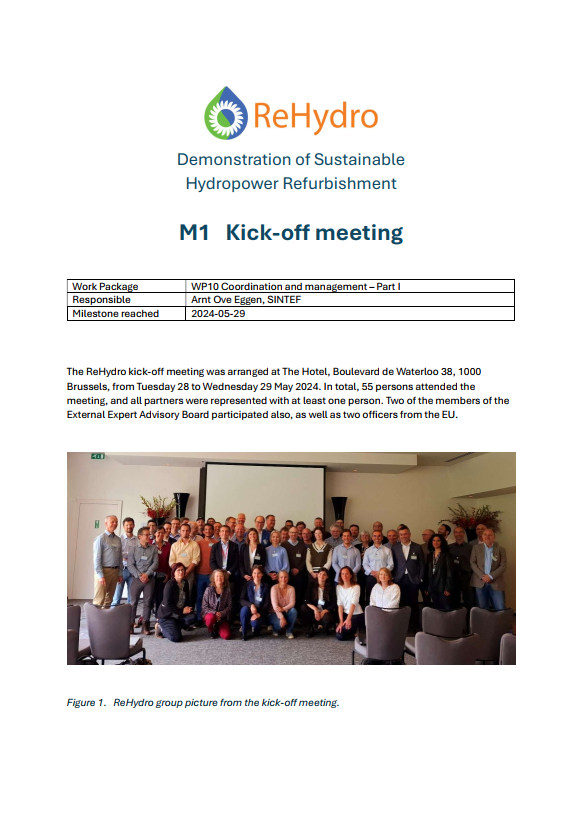

Kick-off meeting in Brussels
WP10 | SINTEF
May 2024
June 2024

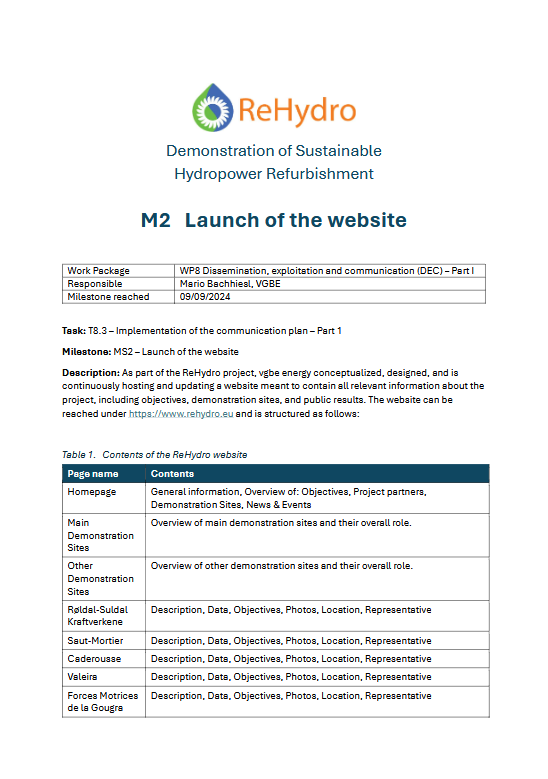

Launch of the website
WP8 | VGBE
June 2024
February 2025

Online monitoring system installed in RSK
WP1 | EDP
February 2025
February 2025

Online monitoring system installed in Valeira
WP1 | LYSE
February 2025
April 2025

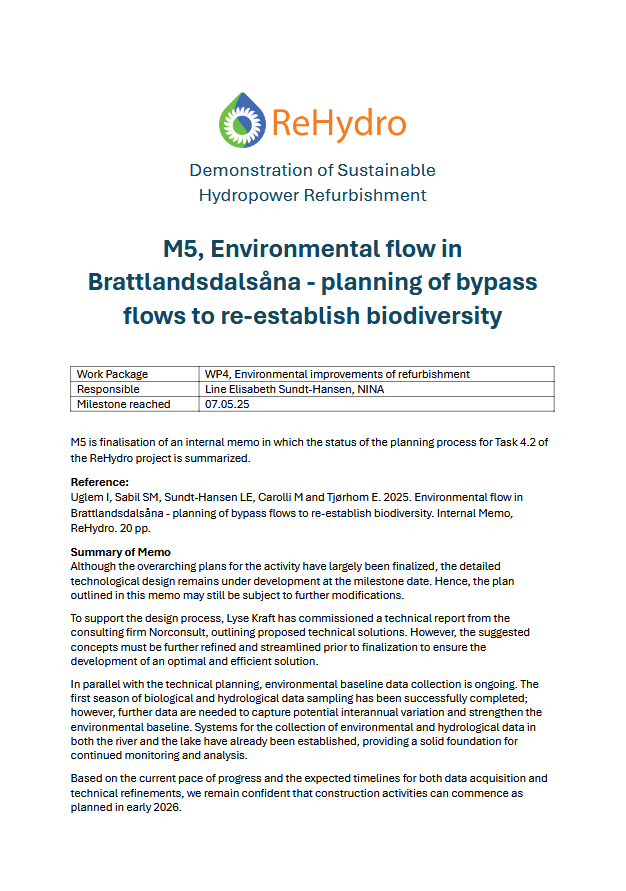

Planning of bypass flows to reestablish biodiversity
WP4 | NINA
April 2025
June 2025

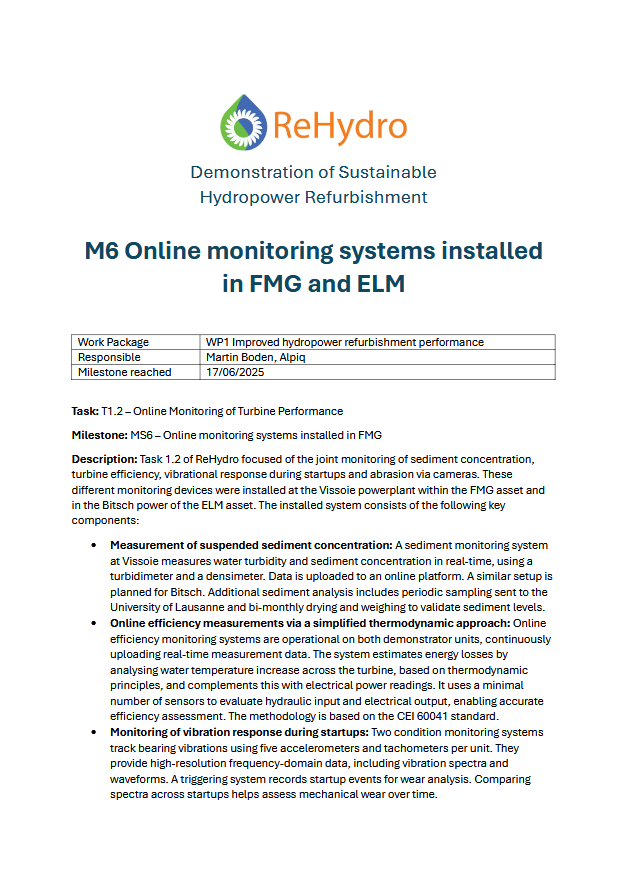

Online monitoring system installed in FMG
WP1 | ALPIQ
June 2025
September 2025

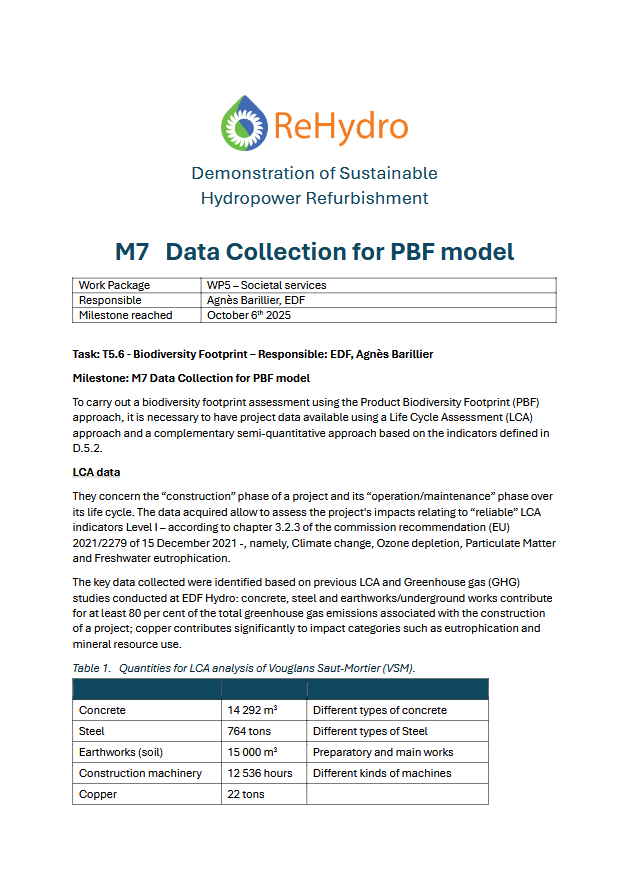

Data collection for PBF model
WP5 | EDF
September 2025
October 2025

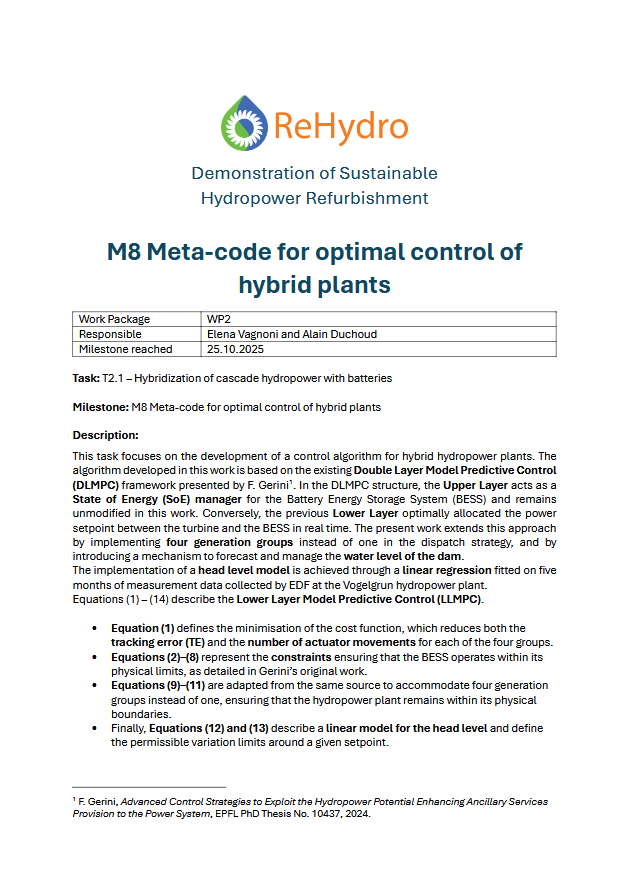

Meta-code for optimal control of hybrid plants
WP2 | EPFL
October 2025
January 2026

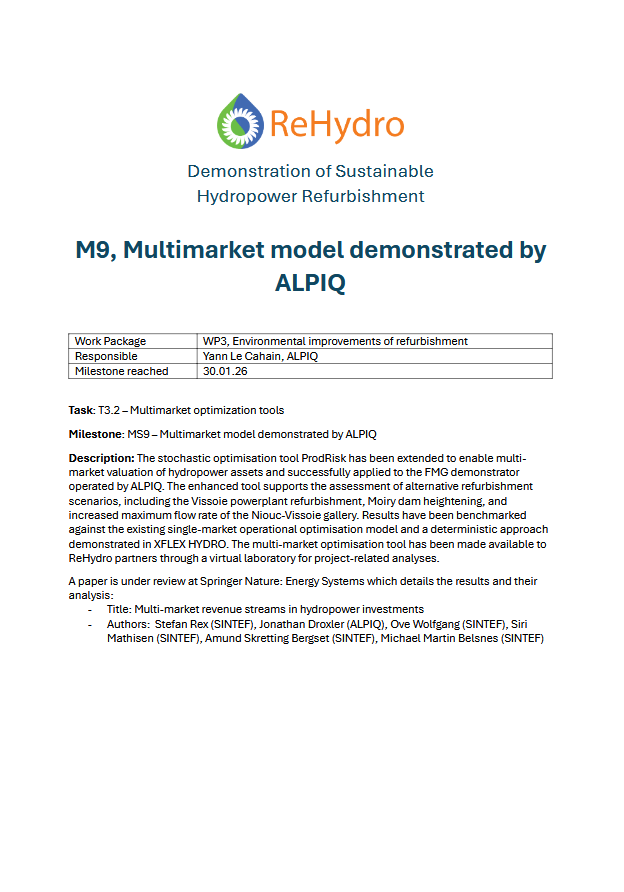

Multimarket model demonstrated by ALPIQ
WP3 | ALPIQ
January 2026
April 2026
Tests completed on hybridization demonstration
WP2 | EPFL
April 2026
April 2026

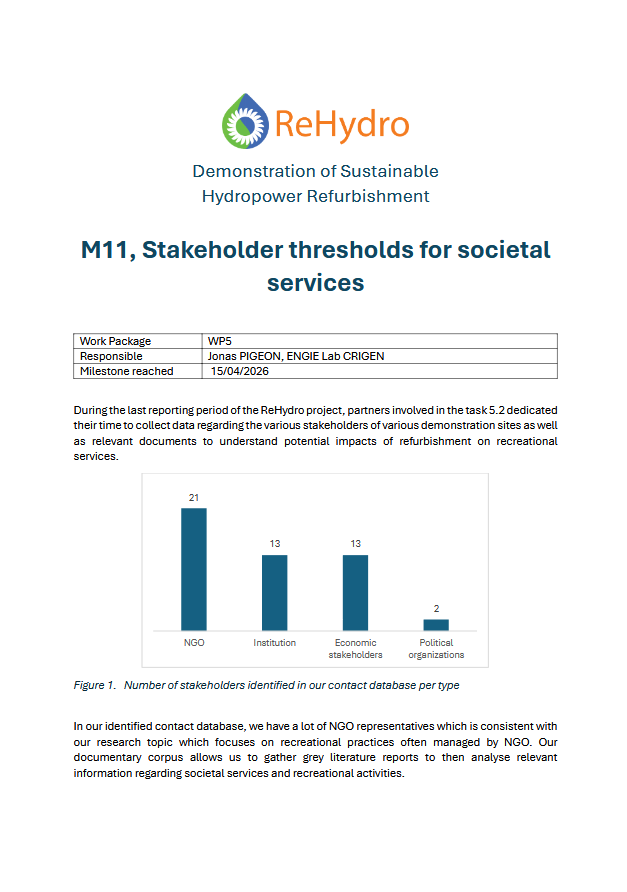

Stakeholder thresholds for societal services
WP5 | ENGIE
April 2026
June 2026

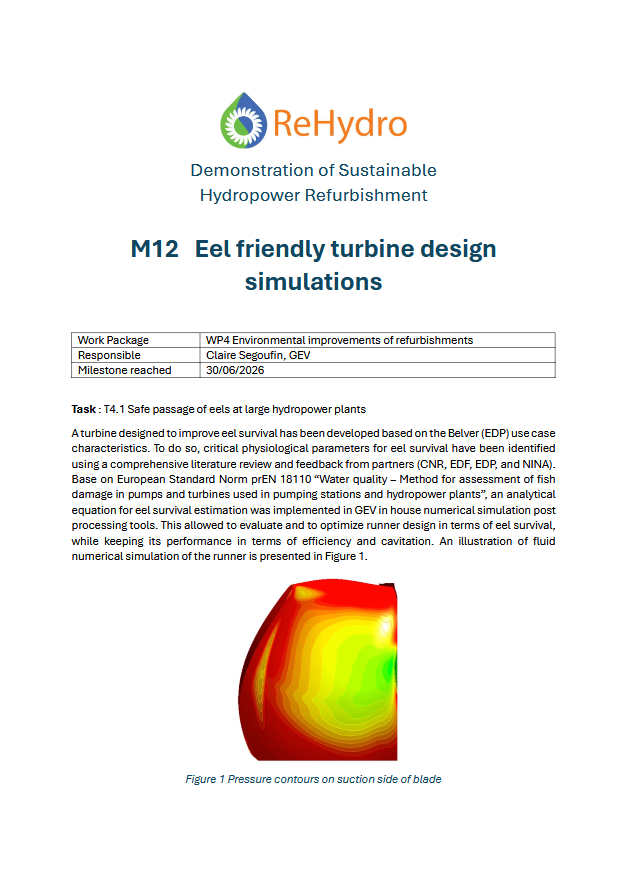

Eel friendly turbine design simulations
WP4 | GE
June 2026
June 2026
Reestablishment of biodiversity in bypassed river
WP4 | NINA
June 2026
June 2026

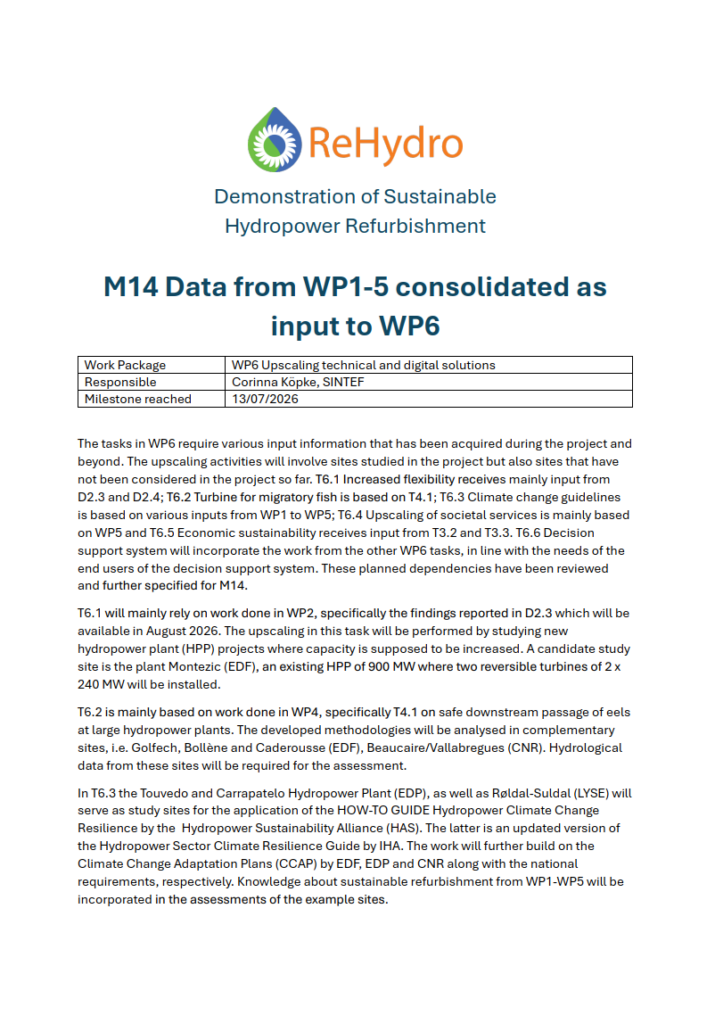

Data from WP1-5 consolidated as input to WP6
WP6 | SINTEF
June 2026
December 2026
Control algorithm implemented for sediments and operations management at Bitsch power plant
WP2 | ALPIQ
December 2026
April 2027
Workshop with relevant EU stakeholders to identify barriers to sustainable modernisation
WP7 | IHA
April 2027
June 2027
Decision support framework
WP6 | SINTEF
June 2027
November 2027
Pumped-storage retrofitting works at Saut-Mortier
WP2 | ALPIQ
November 2027
April 2028
Final event (open conference)
WP9 | VGBE
April 2028

Project Progress
